This document is intended to provide guidance for the reporting and follow up of ISM deficiencies in the scope of a PSC inspection. In the application of the ISM Code during inspections, the following should be observed:
ISM verification is the responsibility of the flag State and the Company and does not fall under the scope of port State control.
The SMS documentation may be in a language not understood by the PSCO. It is not a harmonised procedure if the PSCO looks at the SMS documentation on only those ships where they can understand the language.
The ISM Code applies to all passenger vessels and to cargo ships, regardless of the date of construction, and self-propelled MODUs of 500 GT and upwards, engaged on international voyages.
For establishing the applicability of SOLAS Chapter IX and the ISM Code; “Gross Tonnage” means the gross tonnage of the ship as determined under the provisions of the International Convention on the Tonnage Measurement of Ships, 1969 and is stated on the International Tonnage Certificate (1969) of the ship.
The ISM Code does not apply to government-operated ships used for non-commercial purposes.
During a PSC inspection, the PSCO should verify that the ship carries:
The SMC is not valid unless the ISM Company holds a valid DoC for that ship type. The ship type in the SMC should be included in the DoC and the Company’s particulars should be the same on both the DoC and the SMC.
The PSCO should consider the ISM aspect:
The PSCO should not consider the ISM aspect:

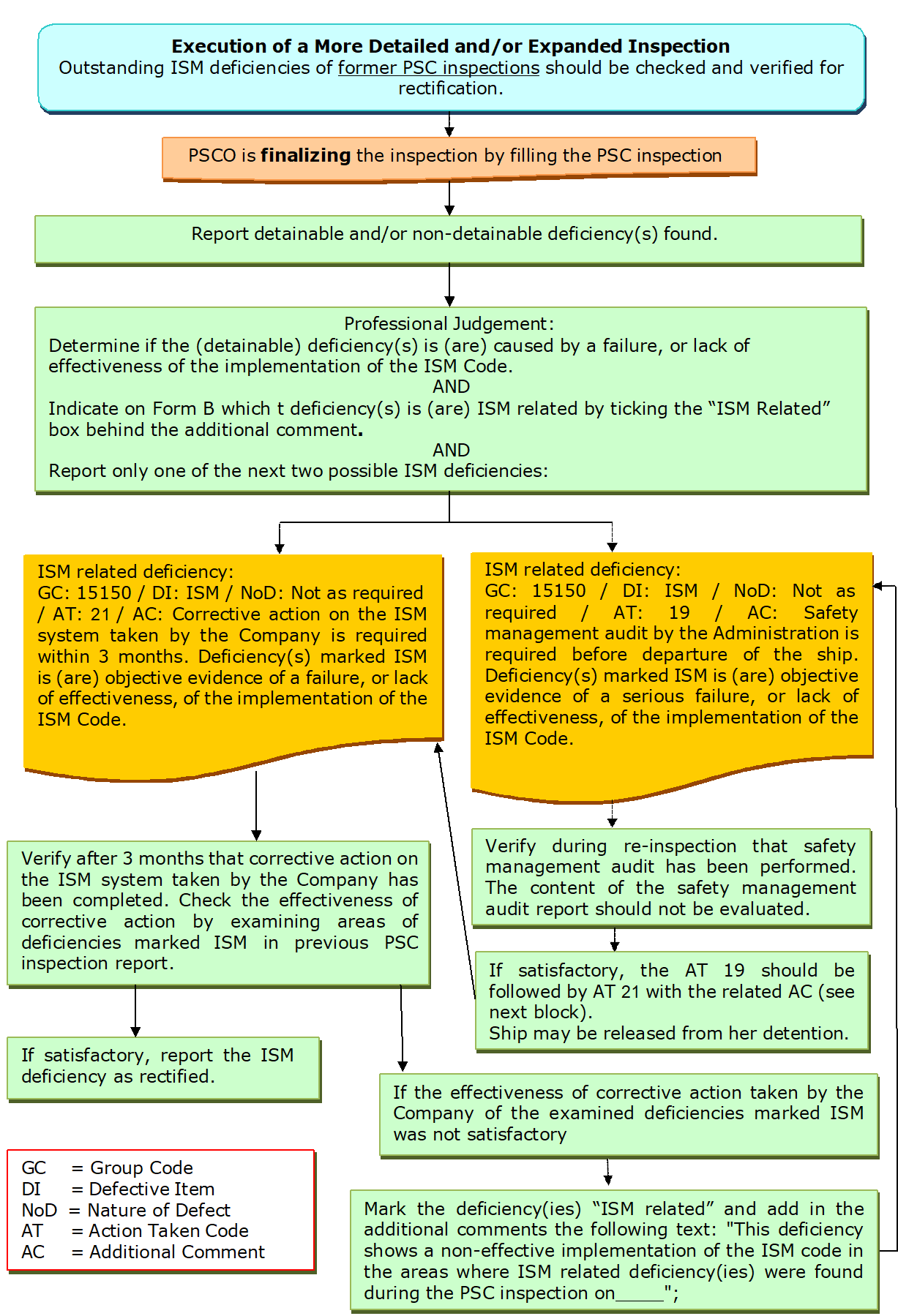

If a deficiency is found on an initial inspection and is considered to be a failure of the effectiveness or implementation of the ISM Code and considered “ISM Related” then this is clear grounds for a More Detailed Inspection and the inspection type should be changed accordingly.
In addition to the clear grounds as outlined in the base instruction[1], PSCOs should consider non-rectified or repeated deficiencies from a previous inspection.
Any deficiencies found during the inspection should be, individually or collectively considered by the PSCO, using their professional judgement, to indicate that either:
If there are deficiencies reported:
Where the PSCO has considered the deficiencies found, and concluded that these provide objective evidence of a (serious) failure, or lack of effectiveness, of the implementation of the ISM Code, one ISM deficiency should be reported in the PSC inspection report. The Convention reference for the Code 15150 deficiency is SOLAS Chapter IX, Regulation 3. There is no need to link the ISM deficiency further to a relevant paragraph of the ISM Code, as in cumulative cases there may be several references.
The deficiencies, which are ISM related, should be indicated in the PSC inspection report by ticking the “ISM related” box behind the additional comment of the particular deficiencies.
| ISM (code 15150) | Action taken | Standard free text |
|---|---|---|
| Grounds for Detention | Safety management audit by the Administration is required before departure of the ship (AT code 19)[2]. | Safety management audit by the Administration is required before departure of the ship. Deficiency(ies) marked “ISM related” is (are) objective evidence of a serious failure, or lack of effectiveness, of implementation of the ISM Code. |
| Not Grounds for Detention | Corrective action taken on the ISM system by the Company is required within 3 months (AT code 21)[3]. | Corrective action taken on the safety management system by the Company is required within 3 months. Deficiency(ies) marked “ISM related” is (are) objective evidence of a failure, or lack of effectiveness, of the implementation of the ISM Code. The ship will be eligible for inspection after 3 months from the date of the last visit of the inspection. |
The follow-up by the Company of the required corrective action taken on the safety management system (within 3 months) or safety management audit (before departure) should not be limited to only the rectification of the deficiencies found.
When releasing a ship detained on ISM (and other deficiencies), the action taken code should change from 19 → 21. Note that the marker “Ground for detention” should remain in the final detention report and not be removed in the database.
The PSCO will verify the effectiveness of any corrective action by examining deficiencies of the previous PSC inspection report which led to the issuance of the ISM deficiency (code 15150) if the due date for rectification has passed. Although an ISM deficiency (code 15150) can only be raised once during an inspection, a ship can have multiple ISM deficiencies raised during different inspections. These ISM deficiencies can be closed out at the same subsequent inspection, provided that the due dates for rectification have passed and deficiencies found rectified without recurrence.
At a subsequent inspection, at least after 3 months, the PSCO should be satisfied with the effective implementation of the ISM Code in the areas where all previous deficiencies, marked “ISM related”, were found.
If upon examination of the deficiencies related to an action taken code 21 are found not satisfactory then the action taken code 21 will be raised to 19 and the vessel will be detained.
During the subsequent inspection the PSCOs should be guided by the “deficiency areas” included in the “THETIS deficiency matrix”; E.g.: in the event that multiple ISM related deficiencies have been described in the same deficiency area and one of these has not been dealt with, this should not automatically lead to a detention of the ship. The PSCOs should use their professional judgement to assess whether the examination was satisfactory.
In case not satisfactory, the PSCO should apply the following procedure:
The PSCO should consider the ISM aspect as per any deficiency related to ISM documentation.
Minor typing errors in the DoC or the SMC should be reported in the PSC inspection report as a deficiency under their respective codes.
[2] The Action Taken code 19 is used only in relation to ISM deficiencies and is displayed in THETIS as “17” and “to be rectified before departure”.
[3] The Action Taken code 21 is displayed in THETIS as “21” and “Corrective action taken on the safety management system by the Company is required within 3 months”.
[4] Refer to point 3.10 of ISM Code for cases of SMC with a period of validity exceeding 5 years.
